- 20 Marks
Question
Joyle Construction Limited is currently working on two contracts with the following details as at December 31.
| Details | Contract A (₦’000) | Contract B (₦’000) |
|---|---|---|
| Material | 16,140 | 23,100 |
| Wages | 61,900 | 23,136 |
| Expenses on site | 8,270 | 10,344 |
| Plant purchased | 191,000 | 78,000 |
| Accrued wages | 5,060 | 2,690 |
| Materials as at 31/12 | 2,670 | 7,680 |
| Value of work certified | 140,000 | 102,000 |
| Cash received on certified work | 119,000 | 76,500 |
| Completed work not yet certified | 4,450 | 2,640 |
| Head office charges apportioned | 15,660 | 12,230 |
| Plant value as at 31/12 | 152,800 | 62,400 |
The contract value is ₦500,000,000 for Contract A and ₦350,000,000 for Contract B.
Required:

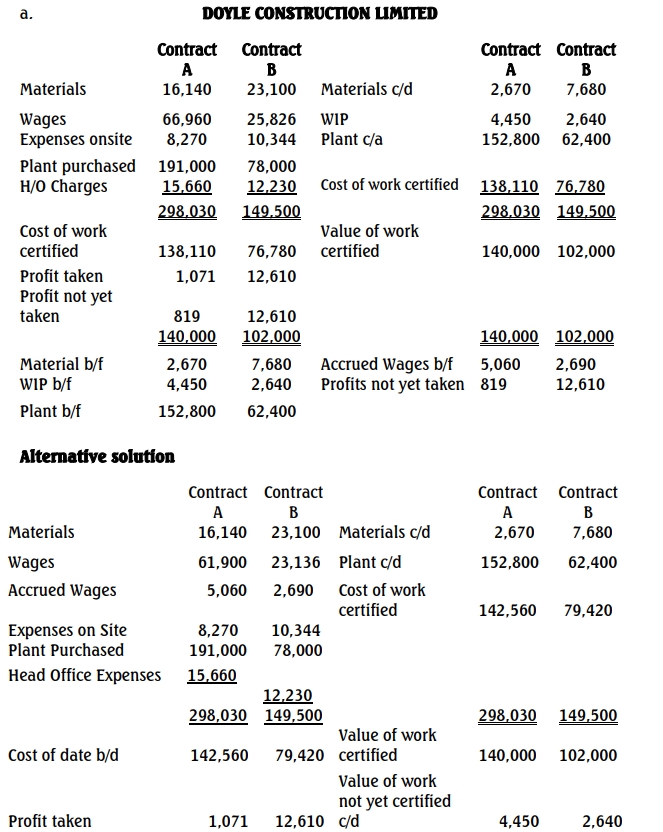

Prepare contract “A” and contract “B” accounts for Joyle Construction Limited as at December 31 in a columnar form. Show the profit taken at year-end and the balances carried forward. (Show workings where necessary).
